Timeline

TIMELINE

MARCH 2025

Multiple M&E tasks completed. Installation of turbine and Pump complete.

FEBRUARY 2025

Lower Reservoir Roof erected

JANUARY 2025

Upper reservoir buried and connected.

BBC visit site: View Video

DECEMBER 2024

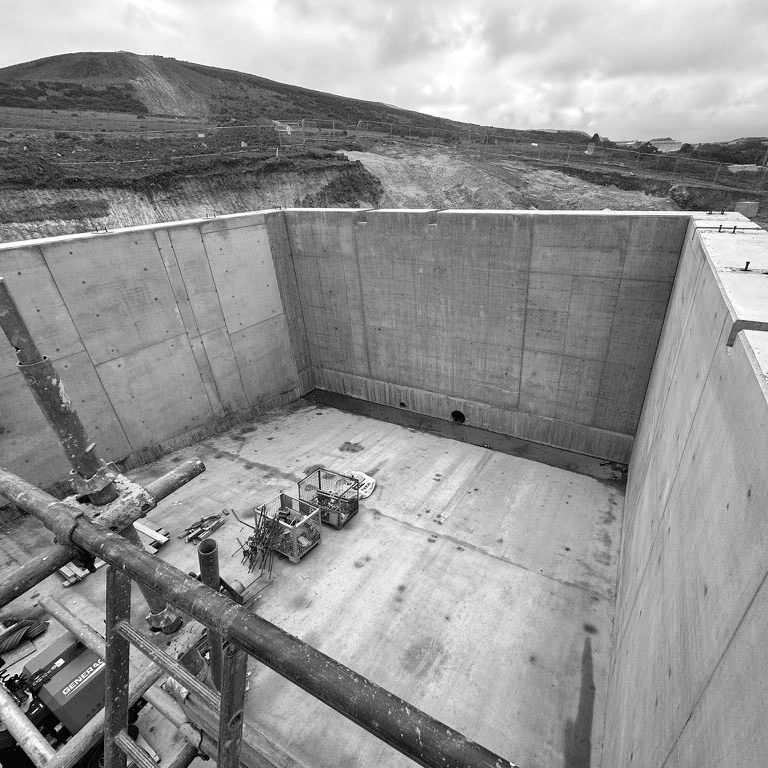

Lower reservoir walls complete. Steels erected. Fluid mixing area  constructed. -

 view the video here

OCTOBER 2024

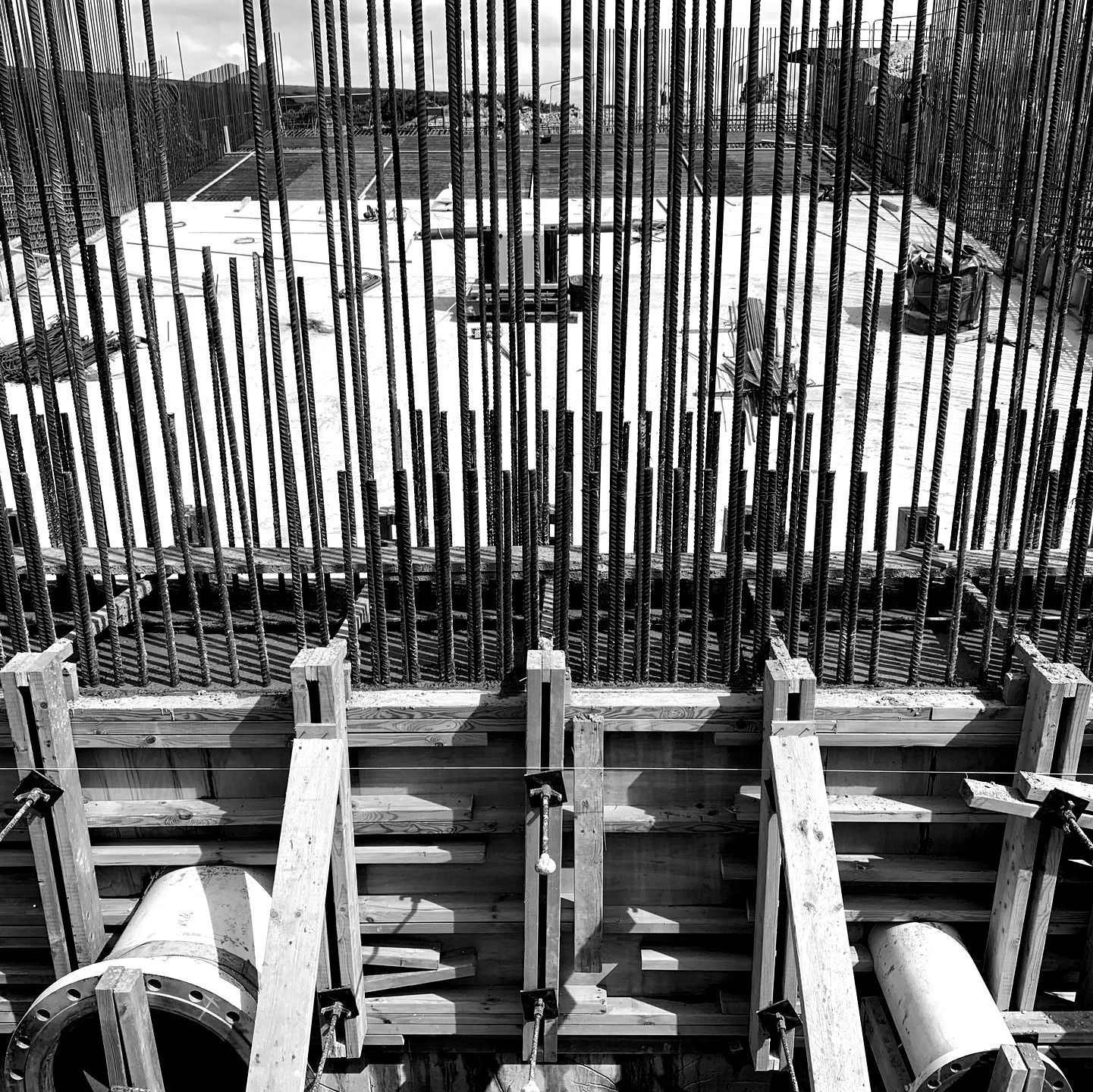

Lower reservoir and powerhouse 60% compete; Pumps and turbine both delivered.

AUGUST 2024

Visit to Poland to inspect pipes - See on LinkedIn

JUNE 2024

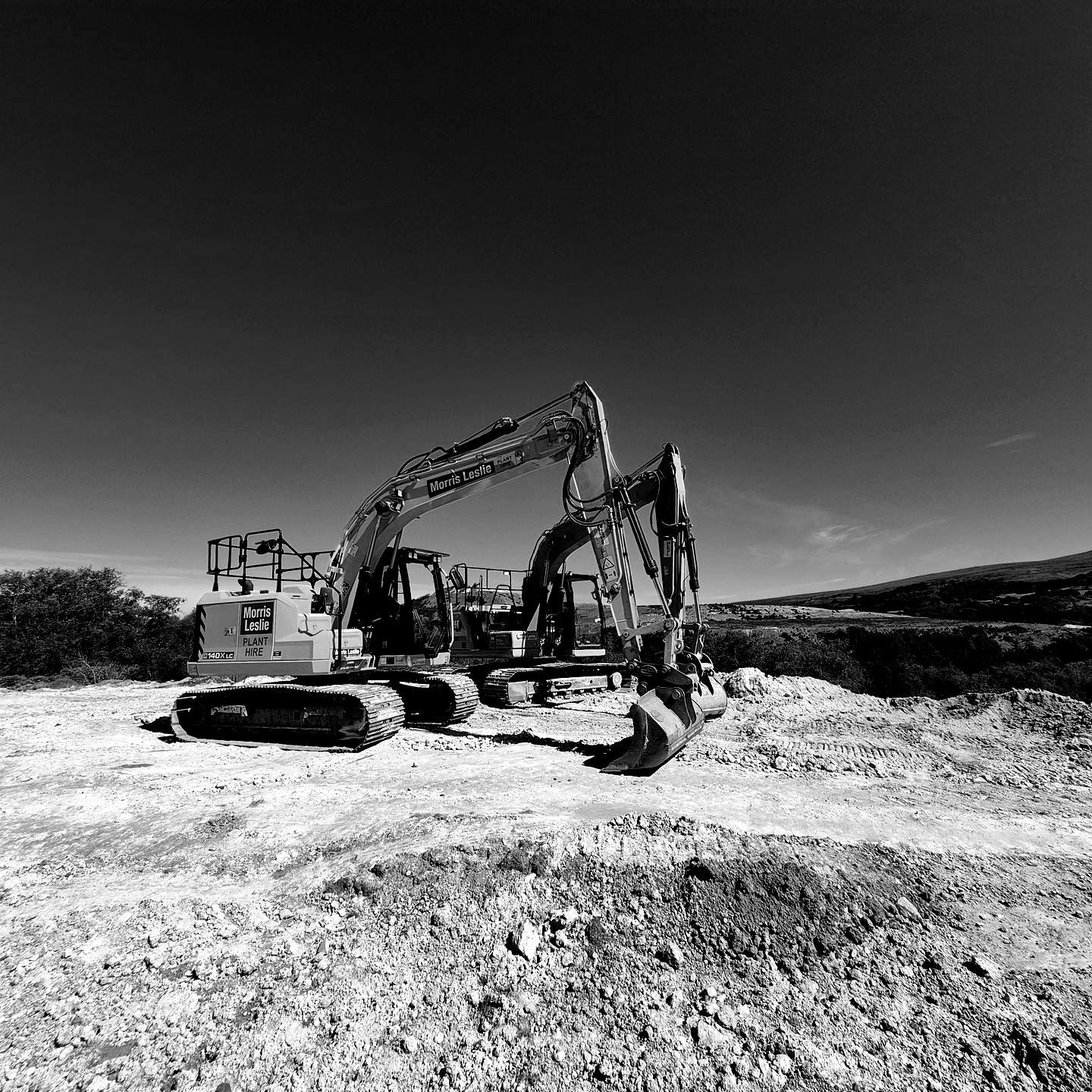

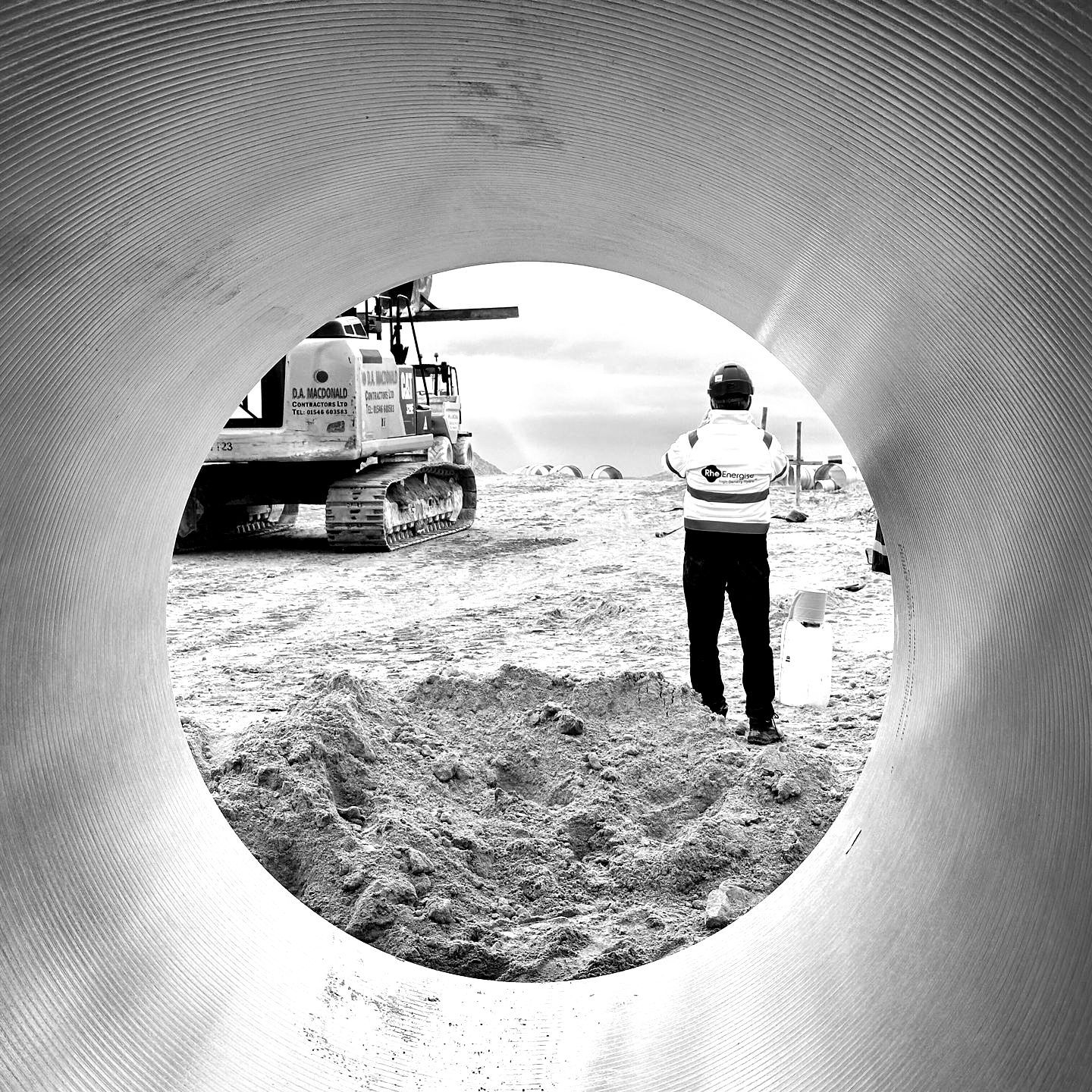

Works on demonstration site in Devon have started

MAY 2024

Reached 30 employees

MARCH 2024

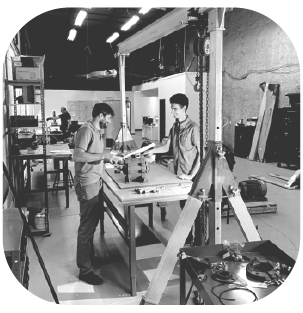

Our HD-Fluid is mixed in our lab for first full scale demonstrator.  See on LinkedIn

MARCH 2024

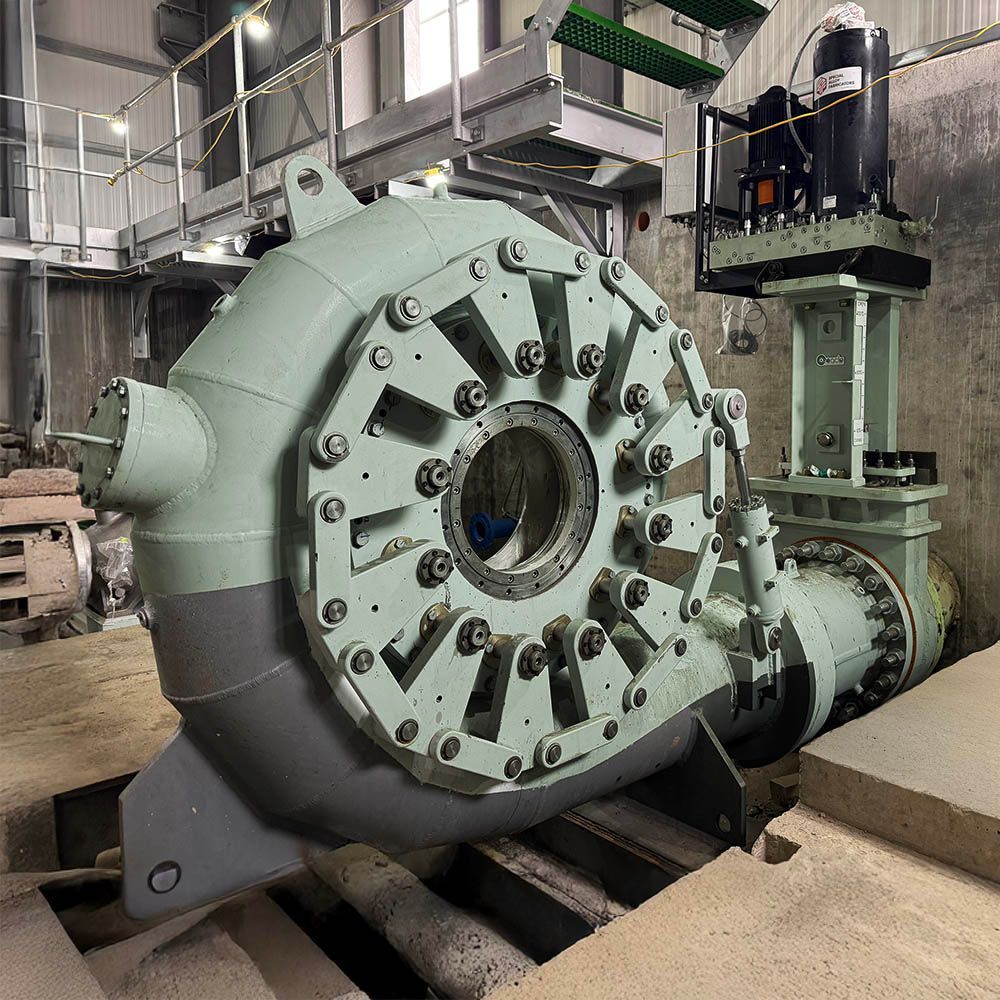

Quality control trip to Hydro Power Engineering. See turbine here

SEPTEMBER 2023

First commissioning test of low-pressure flow loop, Read more here

SEPTEMBER 2023

Reached 25 employees including 5 PHDs

JUNE 2023

Completed HD Turbine designs and placed orders for manufacture - Press Release

JAN-MARCH 2023

Fluid preparation at HTC

Watch video on LinkedIn

JAN- MARCH 2023

£1.8m Seed 2&3 rounds

OCTOBER 2022

Reached 15 employees including  three  PHDs

SEPTEMBER 2022

Commercial Director joins RheEnergise in UK office.

JULY 2022

System field test in Canada

Watch a video of the day

JULY 2021

Fluid formulation grant awrd

MAY 2021

First full time employee - See our team page

MARCH 2021

£888k Seed round one

FEBRUARY 2021

RheEnergise introduced to

the world - Read Guardian Article

2019 - 2020

8 Grant awards

Totaling £820k

Share by:
